It's only two months since the office was decorated and officially put into operation,
Can we ensure the normal construction period
Starting from the city, when we evaluate the reasonable period of a project, we will consider four latitudes and ten key points.
We call it "one two three four" internally, that is:
One
premise
For example, many office buildings and stores in Shanghai are only allowed to operate from 6:00 p.m. to 8:00 a.m. from Monday to Friday, while the construction of the new park is not subject to this restriction, that is, construction can be carried out on weekends; Another example is that the monopoly of some properties is serious, and the fire control, air conditioning, etc. must be designated by the property construction party, but the progress of this construction party cannot be guaranteed; The "inherent conditions" determined by these properties are called "a premise". Usually, when the project manager of Chengqi first checks the house, he can understand these restrictions clearly before he can start to make the construction plan;
Two
accuracy
The two accurate drawings, as the name implies, are inaccurate and the problems of the closing and detail nodes cannot be exposed. In some extreme cases, the size of the measuring room is not correct, even the important parameters of leakage amount are incorrect, which results in the construction of half time, it is necessary to stop and revise the drawings or design changes before the construction can continue. 100% supporting detail drawing of closing problem is required in the drawing specification of urban space
Before the construction, snap the line 100% on the foundation surface and the finished surface. The foundation surface is black and the finished surface is red.
There are four cases of inaccurate budget,
First, it takes time and effort to explain to the customer why they missed the work and get the customer's understanding;
Second, force customers to bow or stop work;
Third, stop work;
Fourth, decoration companies "eat in"; No matter what happens, it is time-consuming and labor-consuming, affecting the progress of the project.
First of all, in our quotation method, the most likely items of "paste" of decoration project are malicious omissions. After calculation, it is packaged into transparent basic project to realize the non malicious omission. For example: some customers dismantle the old ground, and the difference between the two rooms will be different. Leveling must be done. This kind of foreseen project is firmly put in front of the city. For example, for example, the number of point strong power sockets that customers are very easy to neglect, and the external transportation fee of garbage, we all do "transparent foundation project", which only solves the problem of low opening and high-rise from the system.
Secondly, our budget double track system audit, first of all, after the completion of the budget draft, the budget staff will submit it to the customer manager for audit;
Secondly, before the on-site inspection, the draft budget and drawings will be handed over to the project manager, who will review them in combination with the on-site situation, drawings and draft budget;
Third, there are many foundation projects related to the original space situation, so we will add a quotation for the restoration of the original project on site in the signing of the construction contract. For example, the original space has been prepared latex paint, need to be polished with bandage treatment, can brush again, otherwise 100% cracking. This part of the project will be reflected in the quotation.
Three
major
Three specialties reflect the implementation of the interior management standard of decoration company: the unprofessional of supplier, designer and team leader can greatly reduce the engineering efficiency; Chengqi through strict internal standards, rather than excessive professional service for customers. Every Thursday night is our training night. Repeatedly for the construction personnel, designers, material suppliers for training, teaching and learning. Through experience sharing and case analysis, constantly improve self professional, to ensure the accuracy of the construction period.
Four
timely
In the "four in time", the most easily overlooked two points are material selection and acceptance. We think that in order to carry out the construction site in an orderly manner according to the plan, customers should cooperate with us in "timely selection of materials". This requirement, may feel that most of the decoration companies will not tell customers, may be for the convenience of signing, may also be due to loose internal management. For example, when a plasterer enters the site, if the ground
For the floor, the wall is made of marble. When we play the line in the mud, we must know the thickness of the floor, the height of the skirting line, and the paving method of marble (dry hanging? Or wet paving, If the floor is uncertain at this time, we will not be able to judge the height of the ground leveling and the height of the finished surface; If the skirting line is uncertain, the starting height of marble wall can not be judged; If the marble is uncertain, it is impossible to judge the closing way around. Therefore, we have time limit requirements for material selection, which is divided into four nodes that must be completed, that is, before the construction starts, within 7 days after the construction starts, within 3 days after the hydropower acceptance, and within 3 days after the mud wood acceptance, we need to complete the material selection work at the corresponding stage.

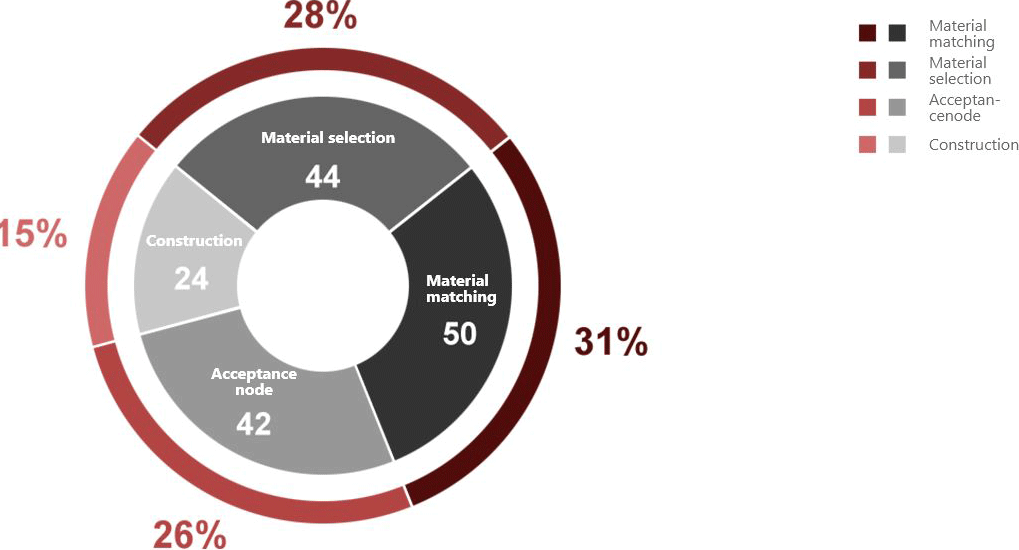

Second is the acceptance, the vast majority of the decoration company's acceptance, only three times, water and electricity acceptance, mud wood acceptance, completion acceptance. Each time the acceptance, just a few minutes, that is, the acceptance. This is also one of the reasons why many customers are not at ease with decoration companies and advocate the third-party supervision. From the beginning of the city, each project has no less than 28 times of sub item acceptance, which can be divided into four aspects: materials, sub items, nodes and materials. Our construction schedule, acceptance and node accounted for 26%, interspersed with each acceptance in the construction schedule, is a test of the ability of a decoration company construction organization.
Many customers are unfamiliar with the word "construction organization", which means that the contractor of the project makes scientific and reasonable arrangements for the five elements of manpower, capital, materials, machinery and construction methods required by the project. Usually through internal disclosure
It will come true. The internal disclosure meeting is usually held within 3 days before the commencement of the project. The participants include the constructor, supervisor, team leader, designer and customer manager. Meetings usually take four months

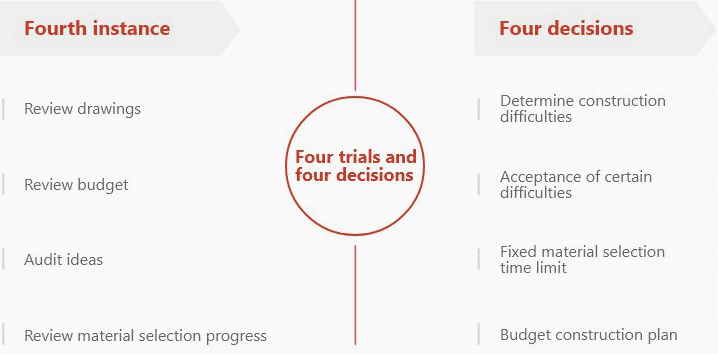

We call it "four reviews and four decisions", that is:
Delay the construction progress and damage the owner's interests.

Four dimensions and ten key points from the city to ensure the transparency of the project in an all-round way!
